General Contractor Estimate Guide 2026

A general contractor can price every trade on a set of plans and still underbid the project. The missing costs often sit between trade scopes: who removes demolition debris, supplies temporary protection, patches openings after rough-ins, coordinates inspections, or supervises subcontractors on site?

Each item may seem small on its own. Together, they can turn a competitive bid into a project that demands more labor and management time than the contract price covers.

A general contractor estimate must account for the entire cost of delivering the project, including work that does not belong neatly to one trade. It also needs to show clients exactly what they're paying for and where assumptions could change the final price.

This guide explains the four estimating terms GCs encounter, how to calculate markup and profit margin, and how to build a complete estimate. It also covers subcontractor bid comparisons, common costing mistakes, and when estimating software becomes more useful than a spreadsheet.

Key Takeaways

  • Preliminary and detailed estimates describe the stage of estimate development; quantity-based estimates describe a calculation method, while bid estimates support a formal submission.
  • Separate direct project costs, site general conditions, company overhead recovery, risk allowances, and intended profit. Count each cost only once.
  • Compare subcontractor quotes against equivalent scope, exclusions, specifications, and schedule before selecting a bid.
  • Markup is calculated on cost, while gross margin is calculated on revenue. Industry benchmarks are not universal pricing targets.
  • Keep the approved estimate as a baseline and review actual costs and the expected cost of remaining work while the job is underway.

What Is a General Contractor Estimate?

A general contractor estimate forecasts the cost of delivering a construction project, including labor, materials, subcontractors, equipment, permits, and project-specific expenses. The contractor uses that internal cost estimate to establish a proposed selling price that also recovers company overhead and provides for intended profit.

The internal estimate is the financial baseline for the GC. The client-facing proposal explains the scope, price, assumptions, exclusions, and commercial terms. The two documents need not disclose the same level of internal cost detail.

Four Common Construction Estimating Terms and When to Use Them

These four practical terms overlap: some describe how developed an estimate is, others describe the calculation method or the purpose of the submission. AACE International's cost estimate classification guidance uses five classes, primarily based on the maturity of project definition, and includes a recommended practice for building and general construction. The table below is a practical terminology guide, not a formal four-class system.

Estimating term What it means When you use it
Preliminary estimate An early cost projection based on incomplete plans, initial scope, and broad assumptions During feasibility discussions and initial budget planning
Detailed estimate A line-by-line breakdown of expected project costs, based on developed drawings and specifications When preparing a reliable internal budget or formal proposal
Quantity or unit-cost estimate A calculation using measured quantities multiplied by unit costs When pricing materials, labor, and work packages from a takeoff
Bid estimate A cost and pricing estimate prepared to support the formal bid submission When preparing a formal bid or proposal

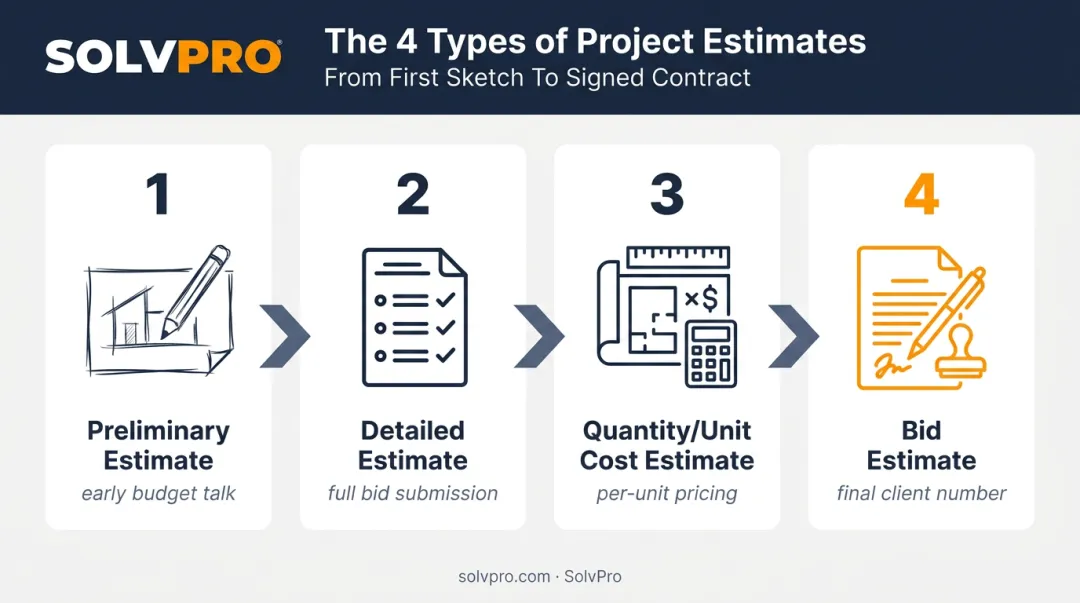

Four types of construction estimates across the project timeline

A preliminary estimate may use broad allowances for plumbing or electrical work. A detailed estimate should replace those assumptions with measured quantities or trade-specific pricing where available. Quantity-based calculations can be part of a detailed bid estimate. Keep measured quantities, confirmed quotes, and remaining assumptions distinguishable so a detailed-looking estimate does not suggest more certainty than it actually has.

What Do Most General Contractors Charge? (Markup and Profit Margin Explained)

There is no dependable nationwide markup that every GC should charge. A remodel, commercial tenant improvement, and new-build project carry different coordination demands, risks, subcontractor responsibilities, and overhead. Price to recover your own costs and achieve the return your business needs.

For context, NAHB's 2025 builder study reported an average gross profit margin of 20.7% and net profit margin of 8.7% for single-family builders in 2023. Its 2026 remodeler study reported average gross and net profit margins of 29.9% and 6.3% respectively for residential remodelers in 2024. These business-level averages are not recommended bid markups or guarantees of project profitability.

How you charge also depends on the contract. AIA's standard owner-contractor agreements include fixed-price and cost-plus arrangements, with or without a guaranteed maximum price (GMP). Other common arrangements include unit pricing and time and materials:

  • Fixed price or lump sum: An agreed price for a defined scope, subject to the contract's adjustment provisions.
  • Cost-plus: Reimbursable costs as defined by the contract, plus an agreed fee.
  • Guaranteed maximum price: Cost of the work plus a fee, subject to an agreed cap and permitted adjustments.
  • Unit pricing: Agreed unit rates multiplied by measured quantities of work.
  • Time and materials: Charges based on agreed labor rates, material costs, and applicable fees or markups.

Markup and Margin Are Different Calculations

Markup measures the amount added to a defined cost base. Gross margin measures the share of revenue left after cost of sales. Use the same cost classification throughout the calculation.

Markup (%) = (Selling price − Cost base) ÷ Cost base × 100

Gross margin (%) = (Revenue − Cost of sales) ÷ Revenue × 100

Selling price = Cost base ÷ (1 − Target margin as a decimal)

Consider a hypothetical fixed-price project with $100,000 in estimated project costs, including direct costs and site general conditions treated as cost of sales. Assume there are no other project costs in this example. The table shows the relationship between markup on that cost base and planned gross margin.

Markup on cost Selling price Gross margin
10% $110,000 9.1%
20% $120,000 16.7%
25% $125,000 20.0%
50% $150,000 33.3%

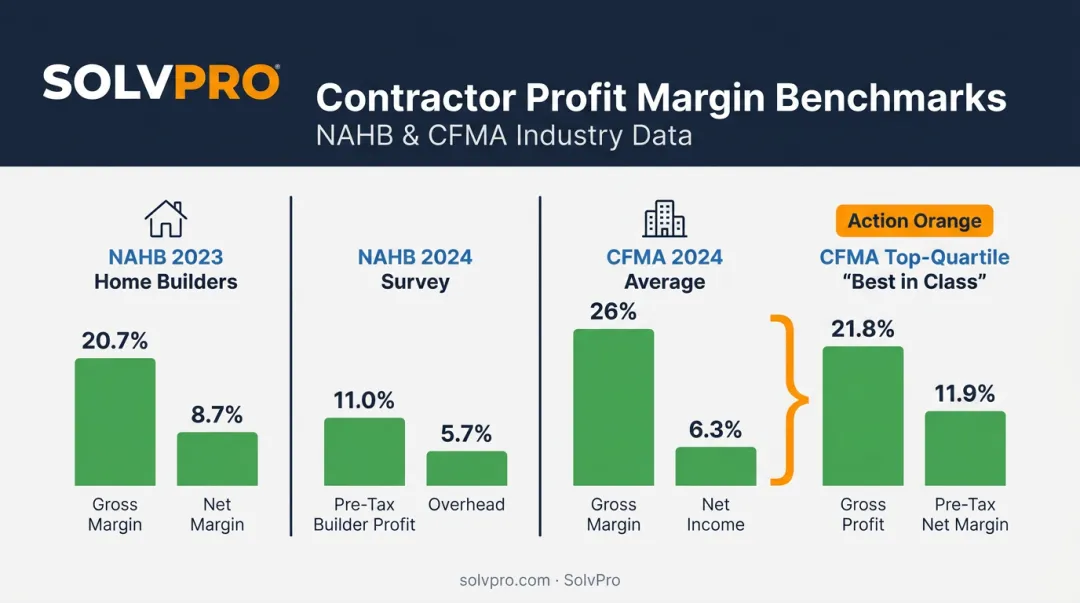

Gross margin and net margin benchmarks from NAHB and CFMA data

A 25% markup produces a 20% gross margin, not a 25% margin. To achieve a 20% planned gross margin, divide the $100,000 project cost by 0.80 to arrive at a $125,000 selling price. The $25,000 difference is planned gross profit, not take-home pay.

If you allocate $10,000 of company overhead to this job, $15,000 remains before other business expenses and taxes, equivalent to 12% of the selling price. Alternatively, you can include allocated overhead in your pricing cost base and target the margin remaining above that broader base. Do not call that margin gross margin unless it matches your cost-of-sales classification, and do not add or recover the same overhead twice.

How to Build an Accurate General Contractor Estimate (Step-by-Step)

An accurate GC estimate starts with the scope, not the final number. The Whole Building Design Guide's cost-estimating guidance and the GAO Cost Estimating and Assessment Guide emphasize defining the work, documenting assumptions, using a consistent breakdown, evaluating risks, and updating estimates with actual costs. Use these eight steps to build an estimate you can check and use after work starts.

1. Review the Complete Bid Package Before Pricing

Start by reviewing the latest drawings, specifications, addenda, schedules, bid instructions, and relevant correspondence. A price based on an older drawing set may miss revised dimensions, new materials, additional work, or changed performance requirements.

Record document versions, requests for information (RFIs), responses, and relevant addenda. Track unanswered questions and check whether clarifications are incorporated into the bid and agreed contract documents.

If the drawings and specifications conflict, request clarification before pricing. If uncertainty remains, state the assumption explicitly and confirm its treatment in the final agreement. Stating an assumption in an estimate does not by itself override contractual obligations.

2. Divide the Project Into Trades and Work Packages

Break the work into identifiable phases, trades, or cost codes. A commercial project might include site preparation, demolition, concrete, structural work, framing, plumbing, HVAC, electrical, finishes, and final commissioning.

The breakdown should also identify work that falls between trades. For example, an electrical subcontractor may include installation but exclude wall repairs after access openings are closed. Another contractor may assume the GC is arranging firestopping or final cleanup.

Create a scope-responsibility matrix before soliciting trade quotes. The assignments below are illustrative only; confirm actual responsibilities in each contract.

Work item Illustrative responsible party What to confirm
Demolition debris removal Demolition subcontractor Hauling and disposal fees
Temporary site protection General contractor Installation and maintenance
Openings for electrical work Assigned trade Cutting and preparation
Patching after rough-ins Drywall subcontractor Finished repairs
Final site cleanup GC or assigned subcontractor Areas and completion standard

This prevents two expensive estimating errors: pricing the same task twice or assuming another contractor has included work that nobody has actually priced.

3. Walk the Site and Record Existing Conditions

Drawings explain the intended project. A site visit helps identify what could make the work harder or more expensive to deliver.

Check access for labor, deliveries, machinery, and material storage. Note working-hour restrictions, occupied areas, existing utilities, demolition conditions, and available site services.

For renovation work, note possible concealed conditions such as damaged framing, moisture intrusion, or unexpected utility layouts. A site walk cannot confirm every concealed condition. Where appropriate, arrange authorized specialist assessment or investigation.

Photograph relevant conditions, record unresolved questions, and connect them to your assumptions. Address remaining uncertainty through clearly defined allowances or contingency where appropriate, exclusions, or the agreed change procedure.

4. Complete a Quantity Takeoff

A quantity takeoff identifies how much material and work the project requires. It converts the drawings and specifications into measurable quantities that can be priced using supplier rates, labor production rates, or subcontractor quotations.

Choose units that match the work: cubic yards for concrete, square feet for flooring, linear feet for conduit or piping, and individual counts for doors or fixtures. Record labor separately in individual labor-hours. For example, three workers on an eight-hour shift represent 24 labor-hours, not eight.

For each item, record the quantity, unit, source drawing or specification, unit price, and assumptions. Apply crew production rates consistently with the chosen labor unit.

Material waste should reflect the specific product and installation method. Tile patterns, offcuts, breakage, sheet sizes, and complex layouts may require different allowances. Applying one blanket waste percentage across every material category can distort the estimate.

Where practical, separate material quantities from labor calculations. This makes it easier to update supplier prices without rebuilding the entire estimate.

5. Collect and Compare Subcontractor Bids

Compare subcontractor quotations against a common scope sheet, the latest drawings and specifications, materials, exclusions, lead times, schedule, quote validity, insurance, bonding, and payment terms. This process is called bid leveling.

Consider two hypothetical electrical bids. Bid A excludes temporary power and testing, while Bid B includes both. Add realistic estimates for the excluded work to compare the same scope.

Cost component Bid A Bid B
Submitted bid $32,000 $35,000
Temporary power $2,000 (excluded) Included
Testing $3,000 (excluded) Included
Comparable estimated cost $37,000 $35,000

Bid A appears $3,000 cheaper at first, but its comparable estimated cost is $2,000 higher. Price is not the only selection factor: verify qualifications, availability, quality, and schedule compliance. Keep the original quotes and comparison notes together.

6. Price Self-Performed Labor and Direct Costs

When you perform work with your own crews, calculate labor using the hours required and the full hourly cost of employing those workers. The wage paid to an employee is only one component of that cost.

Depending on your business and location, the loaded labor rate may include:

  • Base wages and overtime.
  • Employer payroll taxes.
  • Workers' compensation.
  • Employee benefits.
  • Employer-paid insurance and other labor-related costs.

If the work requires 80 individual labor-hours at a hypothetical fully loaded rate of $42 per hour, the estimated labor cost is $3,360. Account for paid nonproductive time, overtime, and applicable employer costs using a consistent method without double-counting. Check applicable wage requirements, including overtime for covered nonexempt employees and prevailing wages and fringe benefits on covered public projects. The U.S. Department of Labor's construction labor guidance explains these federal requirements; state and local rules may also apply.

Include equipment rentals, owned-equipment costs, mobilization, fuel, delivery charges, freight, and disposal where applicable. Check whether these costs are already included in a subcontractor's price to avoid double-counting them.

Use current supplier quotations where possible. Record the quote date and validity period, especially for materials that may have long lead times or changing availability.

7. Add General Conditions, Overhead, and Contingency

Separate the following categories when building the price:

  • Direct project costs: Labor, materials, subcontractors, equipment, and other costs of performing the work.
  • Project overhead or general conditions: Site supervision, temporary utilities, dumpsters, safety provisions, temporary facilities, security, and other job-specific operating costs. Account for project duration, including possible extensions.
  • Company overhead: Office rent, administration, estimating, accounting, and management costs allocated or recovered consistently across jobs. Do not add costs again if already included in the project cost base.
  • Contingency: A provision for remaining uncertainty, including risks related to concealed conditions, material price changes, or duration, according to the agreed allocation of risk.

An allowance is different from contingency: it budgets for a defined item whose selection or price is not yet known. For example, AIA's allowance guidance explains that under standard A201 provisions, a material or equipment allowance generally excludes installation labor, overhead, and profit, which are provided elsewhere in the contract sum. Check the actual agreement, including how allowance adjustments, contingency use, escalation, and customer-requested changes are handled.

8. Calculate the Bid and Review the Complete Estimate

Calculate the selling price using a consistent markup or margin method. Check applicable taxes, permits, bonds, insurance, and contract-specific obligations. Review the price against total estimated project costs, risk provisions, company overhead recovery, planned gross profit, and the amount remaining after allocated overhead.

Have a second reviewer trace significant figures to drawings, measurements, supplier quotes, subcontractor proposals, or stated assumptions. Check missing trade interfaces, duplicate costs, outdated quotes, and incorrect quantities.

Present the agreed scope, proposed price, expected schedule, and conditions for adjustments clearly to the client. Retain the original approved estimate as the cost baseline after award. Record approved changes separately so the original plan and revised budget remain distinguishable.

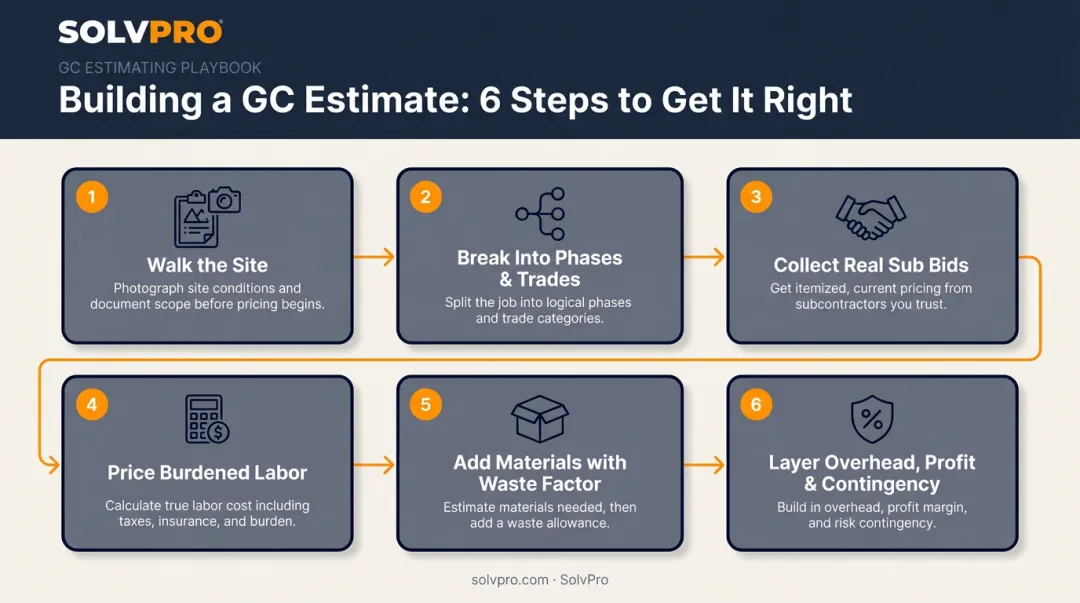

Six-step process for building an accurate general contractor estimate

What Every Estimate Needs Beyond the Numbers

The line-item total is only part of a usable estimate. The client-facing proposal should make the agreed scope and commercial terms clear without requiring disclosure of every internal cost or profit assumption. Use this checklist and adapt it to the project and applicable contract requirements.

Estimate component What it should establish
Project and client details Company, client, project address, estimate number, date, and contact information
Scope of work Specific tasks, trades, materials, and deliverables included
Exclusions Work, materials, or services outside the proposed price
Cost breakdown Price breakdown at the agreed level of detail; internal costs need not all be disclosed
Allowances and alternates Budgeted items, optional work, and unresolved selections
Assumptions Site conditions, drawing revisions, specifications, and pricing basis
Timeline Expected duration and key project milestones
Payment terms Deposits, progress payments, applicable retainage, and final payment conditions
Change orders How added or revised work is priced, documented, and approved
Validity and acceptance Price expiration, customer approval, and applicable terms

A clear exclusion is especially important when the client may assume a task is part of the finished result. For instance, state whether landscaping restoration, furniture removal, appliance supply, or work outside the specified rooms is included.

Make the validity period visible and verify current supplier pricing before accepting a commitment. Also review payment timing, supplier deposits, progress billing, and any applicable retainage: a job can be profitable on paper while the business runs short of cash paying workers and suppliers before customer payments arrive.

Estimate acceptance, deposits, written agreements, and change-order requirements vary by jurisdiction and contract type. For example, California's contractor licensing authority explains specific home improvement contract, deposit, and written change-order requirements. Check the rules applicable to the project rather than treating a signed estimate alone as sufficient.

Common GC Estimating Mistakes That Quietly Eat Your Profit

Use this pre-bid checklist to catch costs that can otherwise be absorbed by the business:

  • Scope: Assign each trade interface and confirm exclusions against equivalent subcontractor quotes.
  • Labor and materials: Check labor-hours, loaded rates, quantities, waste, and current supplier quotes.
  • General conditions: Include site supervision and other duration-dependent expenses without double-counting.
  • Risk and overhead: Separate allowances, contingency, company overhead recovery, and intended profit.
  • Commercial terms: Confirm quote validity, schedule, payment timing, approved change procedures, and applicable contract requirements.

Keep the Estimate Useful After the Job Starts

You shouldn't have to wait until the job is over to find out whether you made money. Return to the $125,000 fixed-price project from the markup example. Suppose the revised forecast of total project costs increases from $100,000 to $112,000, including expected costs of the remaining work. With no additional approved revenue, expected gross profit falls from $25,000 to $13,000, and gross margin drops from 20% to 10.4%. After the same $10,000 allocated company overhead, just $3,000 remains before other expenses and taxes instead of the original $15,000.

That is an 80% reduction in planned profit after allocated overhead. To update a forecast, consider costs incurred, remaining work, outstanding subcontractor commitments, approved changes, and the risks still unresolved. Do not treat costs incurred to date as the final cost of the project. Review the differences while there is time to address them, and use completed-job records to improve future bids.

Estimating Software vs. Spreadsheets: What Actually Protects Your Margins

A spreadsheet can be enough for a contractor handling a manageable number of straightforward estimates. The problem begins when multiple people maintain separate versions, the project scope changes frequently, or the business needs to compare estimated costs against actual job performance.

The right tool depends on which part of estimating is creating the difficulty. Drawing-based takeoffs, cost calculations, client proposals, and job-cost tracking are related tasks, but they are not interchangeable software functions.

Tool type What it helps manage What to consider
Spreadsheet Line items, quantities, unit rates, totals, and basic markup calculations Control formulas, revisions, access, and backups
Construction estimating software Drawing takeoffs, assemblies, cost libraries, trade breakdowns, and bid preparation where supported Check plan measurement, CSI cost codes, revisions, alternates, and subcontractor bid comparisons
Job-management software Estimates and proposals, approved jobs, work orders, labor and material records, job costs, and invoicing Confirm which estimate details carry into the job and how actual costs are recorded

Dedicated preconstruction tools are useful where work requires drawing takeoffs, cost databases, estimating assemblies, CSI cost codes, or detailed subcontractor bid comparisons. Job-management software addresses a different need: keeping estimates, job records, and actual costs available during delivery. Choose tools that fit the complexity of your projects and confirm how records move between them.

Where SolvPro Fits Into the Estimating Process

Winning a job at the right price is only half the challenge. Once your crews start work, you need to know whether labor and materials are staying within the original estimate. SolvPro helps growing contractors connect customer estimates with the work their crews perform and what that work costs.

  • Digital estimates and proposals: Prepare estimates, collect signatures, track approvals, and convert approved estimates into jobs.
  • Scheduling and work orders: Assign crews and keep instructions, notes, photos, materials, and documented changes together.
  • Crew time tracking: Record hours manually or with live timers by job and crew member.
  • Job costing: Compare estimated and actual labor and material costs while work is underway.
  • Invoicing and payments: Create invoices from the office or field, accept card and ACH payments, and track overdue balances.
  • Office, field, and accounting: Use English or Spanish interfaces and mobile apps alongside QuickBooks Online sync. Confirm which records transfer, in which direction, and how edits are handled.

SolvPro job profitability dashboard showing real-time labor and cost tracking

For growing GCs who self-perform work and specialty contractors managing multiple crews, SolvPro helps owners investigate actual labor and material overruns before closeout. For a complete project forecast, also account for subcontractor commitments, remaining work, company overhead, and other costs using the appropriate estimating and accounting processes.

SolvPro pricing is $179 per month for up to three users, plus $49 per month per additional user through 10 users. One core plan, month to month, with no long-term contract or implementation fee. A 14-day free trial is available without a credit card. Usage-based charges may apply for SMS, card and ACH processing, and AI features. Contact SolvPro for larger teams or unusual requirements.

Conclusion

A general contractor estimate should remain useful long after the client accepts the price. Keep the approved scope and original cost assumptions available, record approved changes, and review actual costs against the plan while the job is active.

For contractors managing their own crews, SolvPro connects estimates, job records, labor and material costs, and invoicing so owners can investigate cost differences before closeout.

The goal is to run a profitable shop, not just a busy one.

See SolvPro in Action

Frequently Asked Questions

What Should a General Contractor Estimate Include?

An internal GC estimate should include the scope, direct project costs, site general conditions, risk provisions, company overhead recovery, and intended profit. The client-facing proposal should establish the agreed scope, price, assumptions, exclusions, allowances, payment terms, validity, and change procedures. Match detail to the project and contract requirements.

What Markup Should a General Contractor Charge?

There is no universal markup. Calculate project costs, including site general conditions, once. Determine how company overhead will be recovered and what profit you need. A 25% markup on cost of sales gives a 20% gross margin, not a 25% gross margin. If allocated company overhead is already in your pricing cost base, do not add it again.

What Are the Four Types of Construction Estimates?

Four useful terms are preliminary, detailed, quantity or unit-cost, and bid estimates. They overlap: preliminary and detailed describe development stage, quantity-based estimates describe a calculation method, and bid estimates support formal submissions. AACE's formal classification uses five classes based primarily on project definition maturity.

What's the Difference Between an Estimate, a Quote, and a Bid?

An estimate is a cost projection based on the available project information. A quote generally presents a price for a defined scope under stated terms. A bid is a formal submission responding to a client's or project's requirements.

The terms can carry different contractual meanings depending on the agreement and procurement process. Contractors should make the scope, pricing conditions, exclusions, and acceptance terms clear rather than relying on the document's title alone.

Should General Contractors Mark Up Subcontractor Costs?

A GC may recover coordination, scheduling, quality oversight, contractual responsibility, and payment exposure through the overall contract price or an agreed fee or markup on subcontractor costs. Follow the contract's pricing terms, account for the actual responsibilities and avoid recovering the same overhead twice. There is no universal subcontractor markup.

Is Estimating Software the Same as Job-Costing Software?

No. Estimating software helps calculate expected costs before work starts and may support drawing takeoffs, cost libraries, assemblies, and bid preparation. Job-costing software records and compares actual costs with estimates during delivery. A full cost-to-complete forecast also needs remaining work and commitments. Contractors may need separate tools for these functions.

Run the Job. Protect the Profit.
